Gantt Chart

Project planning is of paramount importance to ensure the success of your objective and allows you to estimate the necessary resources, establish a schedule and define the expected performance indicators.

Projeqtor offers a wide choice of control levers to best plan your project and in precise conditions.

The Gantt chart is a tool used in planning and project management to visualize the different tasks that make up a project over time.

Note

For large projects, with many sub-projects and activities, the number of lines to be displayed is limited in order not to deteriorate performance, even if the project selector has already contextualized the display.

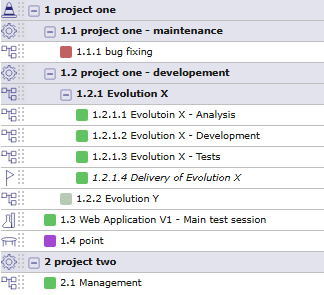

Five areas of Gantt Chart

Six areas of Gantt Chart

Toolbar

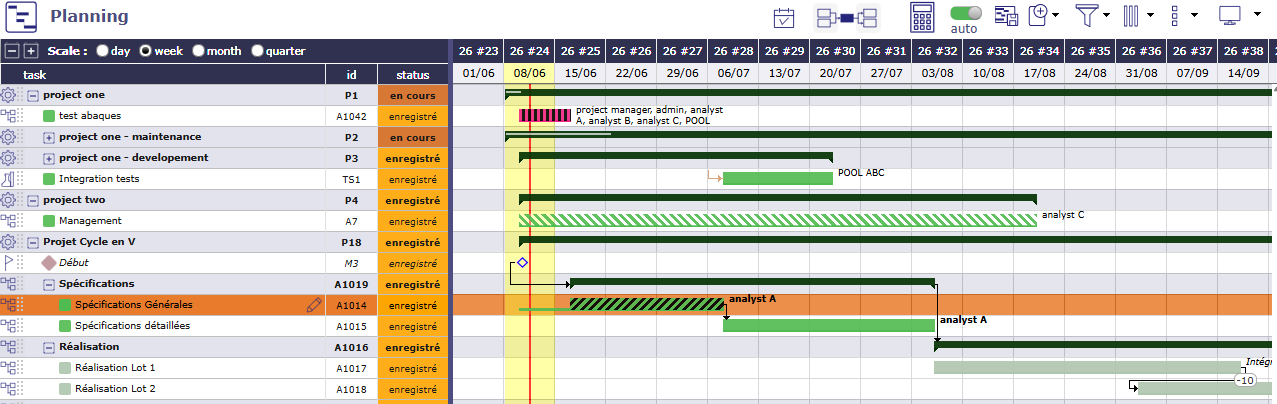

Gantt chart's toolbar

Gantt chart’s toolbar

The tools are dedicated to the planning view.

Scroll to today

By clicking this button, you force the Gantt display to return to the current day.

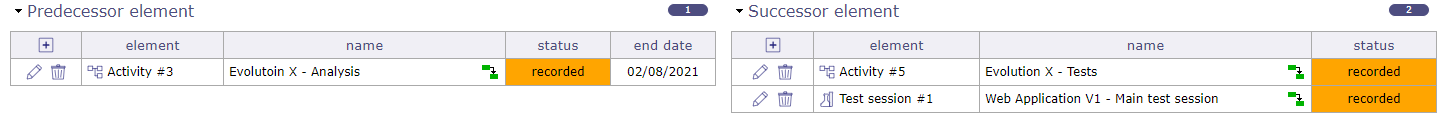

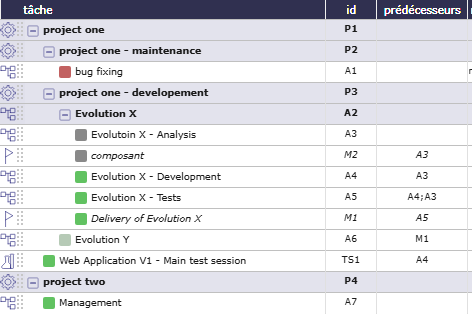

Predecessor and Successor

This functionality allows you to display the predecessors and/or successors of a plannable element (project, activity, milestone, etc.)

Click once on Icon predecessor level one to display the first level of predecessors of the selected element

Double-click Icon all predecessors to display all predecessors of the selected element

Click once on Icon successor level one to display the first level of successors of the selected element

Double-click Icon all successor to display all successors of the selected element.

Click on clear to clear the selection of the predecessor or successor

[back]

Quick mode block

In automatic calculation mode, changing most fields causes the schedule calculation to be refreshed.

This specific blocking mode allows you to not update the schedule automatically each time you make changes.

Warning

Some displays may not reflect the correct values

[back]

Planning calculation

When you make a modification on an element of your project, the project must then be recalculated to take it into account.

You have the option of using the automatic calculation function, which, if you make a modification on the planning screen, and only on this screen, will immediately take this modification into account.

If the modification is made on another screen, even if you have selected automatic calculation then, you will have to restart the calculation on the planning screen.

  • Click on calculate planning button to start the activity planning calculation.

  • A popup window appears with the list of projects.

  • The check boxes in the list area allow you to select one or more projects to recalculate.

Project selection popUp for project calculation

Project selection popUp for project calculation

If you have selected one or more projects with Project Selector then the selected projects will be automatically checked.

Choose the date on which you want to recalculate the project.

By checking the “Hide unselected projects” box, you will only have the projects selected in the project selector and they will be automatically checked.

Important

When the schedule calculation takes a long time, with thousands of activities to be scheduled, the existing scheduled work is deleted, then the calculation is performed, and then the new scheduled work is saved.

During the calculation, users who right-click on the activity do not see the data (the scheduled work is deleted). The idea is to delay the deletion of the scheduled work as long as possible, until just before new values are created.

Automatic run plan

Swith the button to activate automatic calculation on each change.

Only works on the Gantt Planning view.

If the modification of an element is carried out on the dedicated screen of the element, then it is necessary to click again on BUTTON to restart the computation

All modifications about assignement (rate, name or numbers of resources, dates…) done are not displayed on the new planning screen until having, for this purpose, activited the planning calculation, either in an automatic run plan or not.

On the contrary, the screen planning will not change even if modifications have been loaded yet.

Automatic calculation

  • Differential calculation = calculation of projects requiring recalculation after being modified.

  • Complete calculation = calculation of all projects

The calculations are programmed according to a frequency of CRON type (every minute, every hour, at a given hour every day, at a given time on a given week day, …)

See also

Global Parameters into the chapter Automatic planning Calculation

[back]

Quick planning

The objective is to be able to perform a quick schedule calculation when the automatic schedule calculation function is deactivated in order to obtain an initial result directly on the modified tasks without having to recalculate the capacity

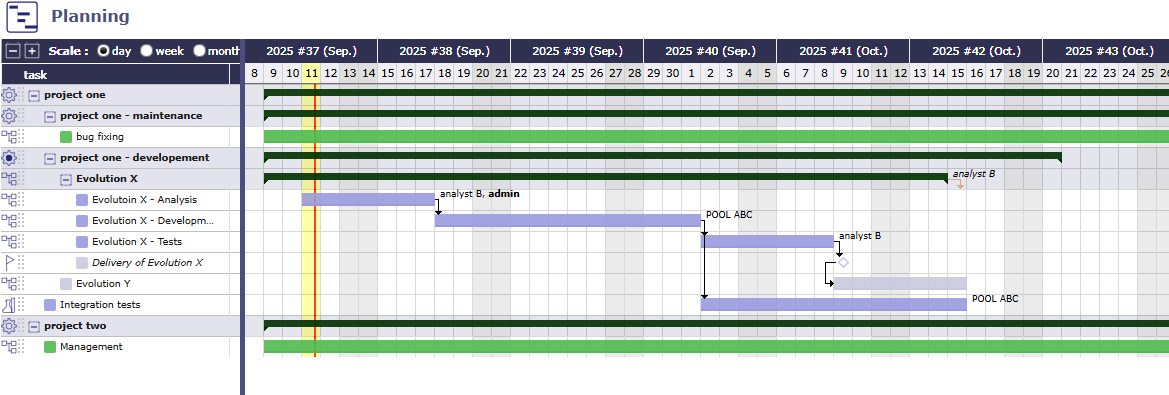

Quick planning activate

Quick planning activate

After modifying an activity, the schedule is recalculated locally to redisplay it without having to call the server.

A call to the server is made in the background to save the modified data and the schedule position of each impacted activity.

Only the activity details are refreshed from the server; the schedule is not refreshed using the server’s data.

Important

Some modifications will necessarily lead to the recalculation of the capacity (from the server).

Consult the impact table.

Quick planning impacts

Triggers

Trigger

NEW

Refresh

OK

Add a line

NEW

Refresh

Delete a line

Refresh

Move a line

Refresh

Indent a line

Split a line (cut in two)

Copy a line

Refresh

Change dates “graphically”

OK

Modify a line - inline

OK

Modify a line - detailed

OK

Modify a line - in pop-up

OK

Add a dependency - inline

OK

Delete a dependency - inline

OK

Modify a dependency - inline

OK

Add a dependency - in Gantt (drag & drop)

OK

Modify a dependency - in Gantt (pop-up)

OK

Add a dependency - in table (pop-up detail)

OK

Delete a dependency - in table (detail)

OK

Modify a dependency - in table (detail)

OK

Add an assignment

Refresh

Modify an assignment

Refresh

Delete an assignment

Refresh

Recalculate

OK

Take dependencies into account

OK

Take parents into account for dependencies

OK

Calculate start dates - end of elementary activities

OK

Calculate start dates - end of parent activities

OK

Calculate milestones

OK

Take Finish-to-Start dependencies into account

OK

Take Start-to-Start dependencies into account

OK

Take Start-to-Finish dependencies into account

OK

Take Finish-to-Finish dependencies into account

OK

Save quick calculation dates

OK

Calculate planning dates

OK

Load planning, not started

OK

Load planning, started

OK

Manage bar display

OK

Planning modes

OK

ASAP - as soon as possible

OK

GROUP - common work

OK

ALAP - finish as late as possible

OK

FIXED - fixed duration

OK

DURATION - duration in hours

OK

WORK - work in hours

OK

DDUR - duration by resource

OK

FDUR - duration by deliverable

OK

FULL | HALF | QUARTER - regular

OK

RECW - recurring work

OK

RECR - recurring resource

OK

REGU - regular work

OK

NRES - cannot start before validated date

OK

STAR - must start at validated date

OK

FIXED - fixed milestone

OK

FLOAT - floating milestone

OK

Overuse (infinite overbooking capacity)

The overuse option allows you to allocate to all the resources and this, on the projects of your choice, maximum overbooking.

This allows you to see the amount of work that is overused for the resources assigned to the task for each period of time.

The overuse option allows you to allocate to all the resources and this, on the projects of your choice, maximum overbooking.

Warning

This function is dangerous, it does not reflect reality.

For this reason, by default, it is not activated, even for the administrator.

See also

Specific access in the Planning access rights section

Overuse

Calculate with the critical path

Check the box to enable critical path calculation.

If this box was not checked during the last calculation then the critical path display option in the Gant chart options will not display anything.

[back]

Baseline

The baseline is a record of the planning state at a time T.

Saved a baseline with the button saved baseline.

Baseline management

Baseline management

  • Enter the project on which to create the baseline.

  • You have possibility to save baselines on all projects.

  • The list of existing baselines, already registered, is available via this window.

  • You can display two baselines on the Gantt chart. Above and below the bars of the Gantt chart.

  • You can create as many baselines as you want per day, but you can only save one baseline per day. Each new baseline must replace the previous one.

  • You can modify your baseline or delete it to save another one.

Error message on baseline management

Error message on baseline management

An alert message notifies you when a baseline has already been performed on the current day.

Display two baselines

Display two baselines

You can display two baselines at the same time. The one above the current activity bars of your project. The other below.

Each of them can be personalized with a different color.

This option will be very useful for you to compare possible drifts and explain them.

Baseline display on Gantt chart

Baseline display on Gantt chart

[back]

Add a new planning element

  • Allows you to create a new planning element.

  • The element is then added under the previously selected element and with the same level of incrementation

  • The element is added to the Gantt chart and the detail area adapts to the content created.

  • The details area allows you to complete the entry.

Popup menu - Create a new item

Popup menu - Create a new item

You can create several elements on the planning view and more on to the Global planning.

[back]

Advanced Filter

The advanced filter allows to define clause to filter and sort.

More details: filters

[back]

Displayed columns

This functionality allows to define columns displayed in the progress data view.

More details: Display and organize the columns.

[back]

Change layout of the screen

You can modify the display of the Planning screen independently of the other screens.

If you choose a vertical display mode globally, you can display the planning view horizontally without modifying the general display.

More details: Change the layout mode

[back]

Display other options

Clicking the icon will bring up the additional options window with the specific tools for the Gantt.

[back]

Display from… to…

Change the start and / or end date to limit or extend the display of a Gantt Chart.

If the display is truncated because the project is too long, think to change the display scale.

All the projet

Check All the project for the Gantt chart to show all project tasks when possible.

Saving dates

Save your dates of display to retrieve them on every connection.

[back]

Other options: checkbox for display

You can display or not, certain information on the Gantt chart.

Show WBS

Click on “Show WBS” to display the WBS number before the names.

Task list with WBS display

Task list without and with WBS Display

[back]

Color on left part

You can apply the color of the project or the plannable element on the list (representing the wbs) and the Gantt’s bars.

color applied to the left part of the gantt chart

color applied to the left part of the gantt chart

See also

Custom color

[back]

Activity colors by type

You can apply the color defined for the activity types directly on the Gantt exactly as when you define it in the management section of your activity.

[back]

Resource

The Resource checkbox allows you to directly display the resources assigned to each activity on the Gantt chart.

Display of initials

Display of initials

Display of initials

Display of name

A user parameter allows you to choose between displaying names or initials.

Choose if you want names, initials or nothing to appear on the Gantt chart.

See also

Tab Display

[back]

Name on bars

You can display the item name directly on the milestone bars including.

A bar that is too small will truncate the name

Bars names

Bar name

[back]

Critical path

This is the longest sequence of tasks that must be completed for the project to be completed on time.

This is a technique for planning and monitoring deadlines

This Take into account the constraints to determine the duration of the project.

The critical tasks that may impact this duration.

Critical Path

Display critical Path on the bar

The red net represents the critical path of the project.

ProjeQtOr offers you a critical chain rather than a critical path.

Tip

Calculate your planning with the critical path checkbox enabled if you want to display it on your Gantt chart.

[back]

Technical progress

When this option is activated, you display the production progress of your work units on the Gantt bar in the same way as the actual work.

You can display both progress bars at the same time on the same activity bar.

[back]

Template project

You can display or hide the template type projects in the area list.

[back]

Closed element

Allows to list closed items on the projects.

[back]

Assignment without left work

Assignments that have no more to do will no longer be visible on the detail.

hide assignment without left work.

Hide assignment without left work.

[back]

Lock bar detail

The detail of the bars is visible with a right click directly on the bars.

By default, this detail showing the dispatch of the planned work for the resources, does not remain displayed when you no longer hover over the bar after the right click.

Activate this option so that the detail remains displayed

[back]

Detail on simply click

Single-click detail allows you to click on the lines of the WBS without triggering online editing and display the task detail with a single click.

In this mode, you can double-click on a line to activate inline editing.

When this option is disabled, inline editing is active.

When you click on a line in the WBS structure the icon button icon Follow up appears at the end of the line. Click on it to see the details.

Click on No View to close the detail

See also

Progress data

[back]

Auto scroll to planning bar

When you click on an item in the list box (WBS) and this item is not displayed/visible directly on the Gantt chart then an auto scroll is executed to this item to visualize it on the chart.

[back]

Planning validation

Allows you to replace the validated dates with the planned dates.

Activate the right in specific access> Planning access right to see this option.

Dialog box - Store planned dates

Store planned dates

With this approach, you validate in a way any possible delay on the activities of your project.

Two actions are available: Always or If empty.

Always

Will overwrite existing values.

If values are entered in the “validated” fields then, they will all be replaced by the planned dates (calculated by the software)

If empty

Will not overwrite existing values.

If the “validated” fields are not completed, then these dates will be replaced by the planned dates.

If the “validated” fields are completed then they will be kept.

[back]

Timeline options

Show or hide the timeline and set the maximum number of lines the timeline should be composed of

See also

project Timeline

[back]

Project Timeline

You can view the timeline of your projects in the timeline.

The timeline allows you to have a faster visibility on the progress in time of your projects.

Timeline

Timeline

The timeline offers a linear view of some selected tasks.

You can add/remove tasks to the Timeline with a single right click.

Add to timeline

Add to timeline

  • Timeline scale automatically adapts to selected tasks.

  • You can hide the Timeline in the Gantt planning view options.

  • You can add milestones.

[back]

Task List: WBS struture

The task list displays the planning elements in hierarchical form by dividing the WBS.

Tasks are regrouped by projects and activities.

See also

The projects displayed depend on the selection made with the Project selector

Task list & progress data view

Task list & progress data view

Show/Hide items

  • Click on the plus or minus of the header area to close and open the groups in the list area.

  • Click on the icons at the top of the list to expand or collapse all project groups at the same time

  • Click on the group row to expand or collapse the group only

See also

Scale

[back]

Icon of element

A specific icon appears to the left of each item type for faster identification.

  • Button icon project Project

  • Replanning schedule Project to recalculate (the Gant diagramm to display with the latest settings)

  • under construction Project under construction

  • Fixed planning Projet fixed in the planning

  • Activity Activity

  • Milestone Milestone

  • Meeting Meeting

  • Test session Test session

Other items can be displayed in the Gantt Chart (action, decision, delivery…)

[back]

Reorder and copy

Reorder the planning

The selector Drag allows to reorder the planning elements.

Note

Ability to move multiple tasks at one time from one location to another using the key control to select the lines and then dragging and dropping them.

Warning

If you move an activity to a new project, the assigned resource must be allocated to the new project to allow this move.

copy lines

You can click on one or more lines to copy them.

Use the Shift key to select consecutive lines and the Control key to select independent lines.

Right-click the selection and choose where you want to copy these lines.

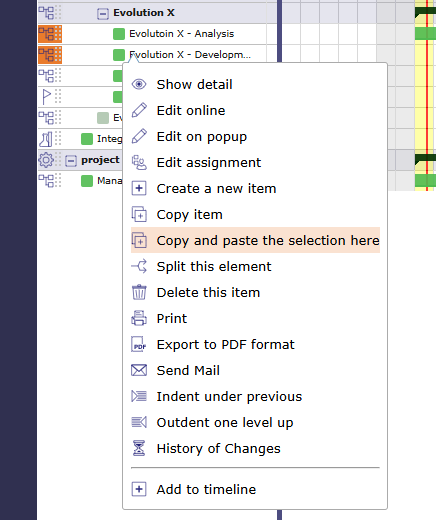

copy lines from wbs

copy lines from wbs

The lines will then be copied after this location.

If any of the copied elements have successors, then the dependencies will be copied as well.

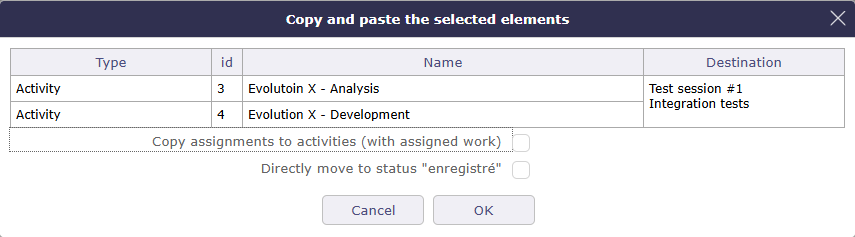

Paste lines from wbs

Past lines from wbs

You can choose to copy assignments to schedulable items as well as copy items to a saved state.

[back]

WBS

Each line corresponds to an element of your project.

This is the structure of your project with all the steps, activities and actions to be carried out to complete it.

In front of each name given to your schedulable element, a dynamic number is assigned.

This number is representative of the level of your element.

If you change the order of the lines by moving elements then these numbers will be automatically updated with all its successors.

Structure list of WBS

Structure list of WBS

The colored blocks in front of the WBS task names reflect the colors of the bars.

  • They are red/light red when a task is late.

  • They are green/light green when the task is on schedule.

  • They are purple when a resource is unavailable for the task.

  • They are gray when the item is closed or canceled.

Tip

  • If the Detail on simply click option is enabled, click on a line to display the detail area

  • If the Detail on simply click option is not enabled, then click on button icon Follow up to view the detail.

See also

detail area.

[back]

Edit on line

Most rows and fields in the displayed columns can be edited from this view.

Click the field once if the Single Click Details option is disabled, double-click if the option is enabled.

You can edit these lines directly on the list.

Each row and each column field can be edited from this view.

Edit on line

Edit on line

Click the field once if the Simple click on details option is disabled, double-click if the option is enabled.

  • Click on Save to recorded the modification

  • Click on Cancel to cancel the modification

  • Click on button icon Follow up to display the detail

  • Click on Button edit to edit the line

  • Click on No View to close the detail

The controls relating to the choice of certain fields, such as for the planning modes, are well executed even in free edit mode.

Either with a single click if the “detail on single click” option is deactivated, or by double clicking if the option is activated.

You can use your keyboard to move around and confirm your changes.

  • Tab to move within the row.

  • , , , keyboard navigation arrows to move between rows and lists.

  • Enter to confirm the change, like Ctrl + S.

  • Double click on the ID to copy it and paste it into the predecessor column

Double click for copy

Double click for copy

Dependancies

Predecessor type dependencies can be displayed in the displayed columns and can be edited online directly.

You just need to fill in the type of predecessor, the ID of the predecessors so that they are taken into account.

  • A1 for Activity #1

  • P1 for project #1

  • M1 for Milestone #1

  • TS1 for TestSession #1

  • MG1 for Meeting #1

  • PM1 for Periodic Meeting #1

example display for ID and dependencies

example display for ID and dependencies

Tip

To add multiple predecessors at once, separate the items with a semicolon or comma.

For example A1;A2 or A1,A2.

Important

If user enters just ID, without letter, consider it is an Activity.

Note

For all the rest of the elements that could serve as predecessors, you can enter the full name directly

For example to create a dependency with an Action as predecessor then enter Action#ID.

[back to WBS] - [back to Chart view]

Context menu

By right clicking on each of the lines you have access to the Gantt submenu which allows you to access certain actions by going through the main menu of the screen.

Right click menu

Right click menu

[back to WBS] - [back to Chart view]

Progress data

The progress data view allows you to visualize the progress of all the elements of one or more projects with their consolidation. Each line corresponds to an element.

To display this information, drag the splitter between the list box and the Gantt chart.

These lines can be edited directly on this view.

Progress data view

Progress data view

For each planning element, the progress data are displayed at them right.

The columns are customizable as on all the other screens of the application.

you can add or remove the columns you are interested in using column management.

Click on Columns organizer to manage them.

Move column

Move column

You can change the order of columns and resize them from this view without going through the column management menu.

Drag and drop the column to the right or the left. Click on the splitter between two column to resize the column.

[back]

Gantt chart view

The Gantt chart view is a graphical representation of the progress data of a project.

For each planning element, a bar is associated with it

Gantt chart view

Gantt chart view

Scale

Scale available: daily, weekly, monthly and quarter.

The Gantt chart view will be adjusted according to scale selected.

When you are in the planning view on the wbs and gantt area and details area, you can move from one scale to another using the wheel control on your mouse.

  • Mouse wheel up to increase the scale*.

  • Mouse wheel down to decrease the scale.

  • When you continue to increase after the semester, then we loop and return to the day scale, the smallest.

  • Outside of these areas, the mouse wheel will increase the zoom of your browser.

[back]

Gantt chart’s bars

The bars in the gantt chart graphically represent a line of your WBS structure.

We visualize the start and end dates and therefore the duration of the task.

The bars displayed in the gantt chart can appear with different colors. Each color has a meaning.

Current date bar

Current date bar

Current date bar

Yellow column indicates the current day, week, month or quarter, according to scale selected.

The red line in yellow collumn display the current day and time.

Pale green bar

Without assigned work

no charge

Condition: Activities without assigned work - Planned end date < or = Validated end date

Green bar

all is well

all is well

Condition: Assigned resources are available and meet workload - Planned end date < or = Validated end date

Pale mauve bar

Without calcul and assigned work and all is well

no charge

Condition: Fast calculation - no calculations between projects were carried out - graphical representation - without load - modifications to the task without taking into account the steering levers - Planned end date < or = Validated end date

Mauve bar

Without calcul with charge and all is well

all is well

Condition: Fast calculation - no calculations between projects were carried out - graphical representation - with load - modifications to the task without taking into account the steering levers - Planned end date < or = Validated end date

Pale red bar

Without assigned work and don't respect the validated date

no charge and date planned is superior to validated date

Condition: Activities without assigned work - Planned end date > Validated end date

Red bar

Overdue tasks

Overdue tasks

Condition: Planned end date > Validated end date - Real end date if completed task > Valited end date

Purple bar

Impossible to calculate

Impossible to calculate the remaining work

Condition: If a resource is not or is no longer available on an activity.

The calculator is trying to plan the workload.

The resource assigned to the activity is unable to be planned for this task (absence, calendar, assignment or assignment periods, etc.); then the bar turns purple.

Pink bar

Thanks to the setting on the management of inherited dates, you will be able to display the pink color to indicate that the end date of this task was recovered from a successor element.

Impossible to calculate

Impossible to calculate the remaining work

Condition: Planning can take into account validated end dates of activities as a priority using a global parameter.

When this option is activated, the validated end date, if it is not provided, is automatically inherited from the successor or parent.

Impossible to calculate

In the case of an inheritance and the Planned end date > Validated end date, the bar turns pink.

Pale pink without workload and bright pink with workload.

Inherited date

Inherited date

When the validated dates are inherited then they are displayed in italics and grayed out whether in the list area or the detail area.

[back]

Special bars

Some features offer different color codes.

Surbooking and overuse bar
Surbooking

Capacity overbooking

Condition: Add extra work time on the standard capabilities of your resources to plan more projects that you will not process.

Surbooking or orveruse view on Gantt chart

Surbooking or orveruse view on Gantt chart

Surcapacity
Surcapacity

Overcapacity of resources

Condition: The capacity of the resource has been changed. It can be under capacity or over capacity. That is to say, it does less or more than its FTE.

Surcapacity view on Gantt chart

Surcapacity view on Gantt chart

Real work

Work in progress

Work in progress

Condition: the length represents the percentage of completion based on the actual progress (Assigned - Real work) versus the length of the Gantt bar.

Technical progress

Technical progress

Technical progress

Condition: the length represents the percentage of completion of the units of work that you enter manually (Delivered - completed) in relation to the length of the Gantt bar.

The technical progress bar is automatically set to 100% if the activity that carries the production has moved to the done state.

You can display both progress bars at the same time on the Gantt chart bar.

Progress bars for actual work and work units

Progress bars for actual work and work units

Consolidation bar

consolidation bar

Consolidation Bar

Condition: graphical display of the dates consolidated by the group of planning elements for a project

Custom colors

You can apply the color of your choice on the bars of the Gantt chart representing activities, milestones and meetings.

If the Planned end date> Validated end date then the bar should be colored red.

In case you have set a custom color, this state will still be indicated by a thin line at the bottom of the bar.

Custom colors n the gantt chart bars

Custom colors on the gantt chart bars

And in the task list, where the indicators remain the original color.

A parameter in the tools box allow to apply the color on the left part of the Gantt chart. See: Apply color on left part

color applied to the left part of the gantt chart

color applied to the left part of the gantt chart

Click on the reset button to come back to original colors.

You can also set a default color based on the activity type.

Bars for color blind

With the help of options, whether in the general settings or in the calculation settings, you can change the colors or have new ones.

The color of the bar adapts to color blind people if you have activated the option.

GREEN BAR

the green color of the bar changed to fluorescent green.

_images/GANTT_BAR_GreenColorblind.png

Enable this option in user parameters

RED BAR

the red color of the bar changed to striped purple to clearly mark the difference.

_images/GANTT_BAR_RedColorblind.png

Enable this option in user parameters

[back]

Item name display

View the item name and planned dates on the selected bar

Item name and planned dates on the selected bar

Move the cursor over the bar to display item name and planned dates.

or activate the “show bar name” check box directly on the Gantt view in the planning screen options.

Dependency

Dependencies allow to define the execution order of tasks (sequential or concurrent).

All planning elements can be linked to others.

Dependencies can be managed in the Gantt chart and in screen of planning element.

Dependencies between planning elements are displayed with an arrow.

Important

Strict mode for dependencies

The strict dependency mode forces the successor planning element not to start on the same day as the same predecessor but the next day. Even if the task is finished before the end of the day.

To have the successor start on the same day or before the end of the predecessor task, select NO for strict mode or you can also put a negative delay.

The strict dependency mode is a global parameter. By default, the strict dependency mode is set to YES.

Create a dependency

To create a dependency, left click on a bar of the gantt (the predecessor) and slide towards the successor.

You can also create dependencies with the predecessor and successor tables at the bottom of the details area.

Remember than the first task always drives the second.

Predecessor and Successor section

Predecessor and Successor section - In the NAME field, icons are displayed to indicate the type of dependencies

  • Click on Add on the corresponding section to add a dependency link.

  • Click on Button edit to edit the dependency link.

  • Click on Delete to delete the corresponding dependency link.

Dialog box - Predecessor or Successor element

Dialog box - Predecessor or Successor element

Modify a dependency

Click on the arrow which turns orange, a pop up is displayed allowing you to modify the type and one to add a possible delay.

The predecessor and successor elements of the dependencies are displayed at the top of the popup.

Tip

Multi-line selection is possible using Control or Shift key while clicking.

update dependency pop-up

Dependencies dialog box

You can change the type of the dependancy. An image accompanies the types to make your choice easier.

You can add a delay on the dependancies. The delay can be positive or negative. Negative delay allows overlapping of certain tasks.

The delay is shown on the Gantt chart and the bubble indicating the delay adapts according to the length of the delay.

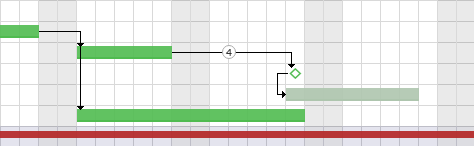

delays on dependencies

Delays on dependencies

The dependency line will be extended by as many days as the deadline entered. Otherwise it will start the next day by default.

Dependency types

ProjeQtOr offers three types of dependency. The fourth type start-End is not represented.

End Start dependency End-Start

The second activity can not start before the end of the first activity.

Start start dependency Start-Start

The successor can not begin before the beginning of the predecessor. Anyway, the successor can begin after the beginning of the predecessor.

End End dependency End-End

The successor should not end after the end of the predecessor, which leads to planning “as late as possible”.

Anyway, the successor can end before the predecessor. Note that the successor “should” not end after the end of predecessor, but in some cases this will not be respected:

  • if the resource is already 100% used until the end of the successor

  • if the successor has another predecessor of type “End-Start” or “Start-Start” and the remaining time is not enough to complete the task

  • if the delay from the planning start date does not allow to complete the task

Hidden dependencies

When dependencies are hidden, project folded or parent activity folded on the planning view for example, then a pale orange arrow is displayed in front of the selected element

It means that this element has a constraint that is not currently displayed on the planning view.

hidden dependencies

Hidden dependencies

The direction of the arrow tells you if it is a successor or a predecessor.

[back]

Milestone

Milestones appear as small diamonds. Filled if completed, empty otherwise.

Color of diamond depends on milestone progress.

Ongoing milestone and in times

Planned end date < Validate end date and the task is not done

_images/GANTT_ZONE_GreenMilestone.png

Completed milestone and in times

Planned end date < Validate end date and the task is done

_images/GANTT_ZONE_FilledGreenMilestone.png

Ongoing milestone and delayed

Planned end date > Validate end date end date and the task is not done

_images/GANTT_ZONE_RedMilestone.png

Completed milestone and delayed

Real end date > Validated end date and the task is done

_images/GANTT_ZONE_FilledRedMilestone.png

[back]

Detail of the work

ProjeQtOr also allows you to see the distribution of the workload assigned to the resources.

Right click on a bar to see the detail.

An option allows you to display the details of a bar rather than only seeing it on hover.

Display details of the work

Display details of the work

The lines are sorted by resource name.

Colors code

Planned workload Planned workload

Real work Real work - charged to the timesheet

Excess workload Excess workload over dates

Real work with Excess workload Real work with Excess workload over dates

Absence Absence of the resource

Warning

You have to selected day, week or month scale to display detail or a message will ask you to switch to smaller scale.

Quarter is not available for th detail.

[back]

Details area

The details area is the same as on all the ProjeQtOr element screens and adapts according to the selected element.
